DEPLOYMENTS

Putthecomputewherethedataalreadyis.

Sovereign data-residency requirements, latency-sensitive inference, industrial sites, and institutions in banking, government and defence that will not export data to a shared facility. For these cases the node removes the dependency on a data hall entirely.

50 °C
Continuous design ambient
IP55
Sealed against dust and salt
~11 kW
Aggregate site design load
600 mm
Plinth — no building required

Deployment envelope

How little building can we get away with?

Removing the data hall means the environment becomes a design input rather than something a facility absorbs. What remains is a short list of site requirements.

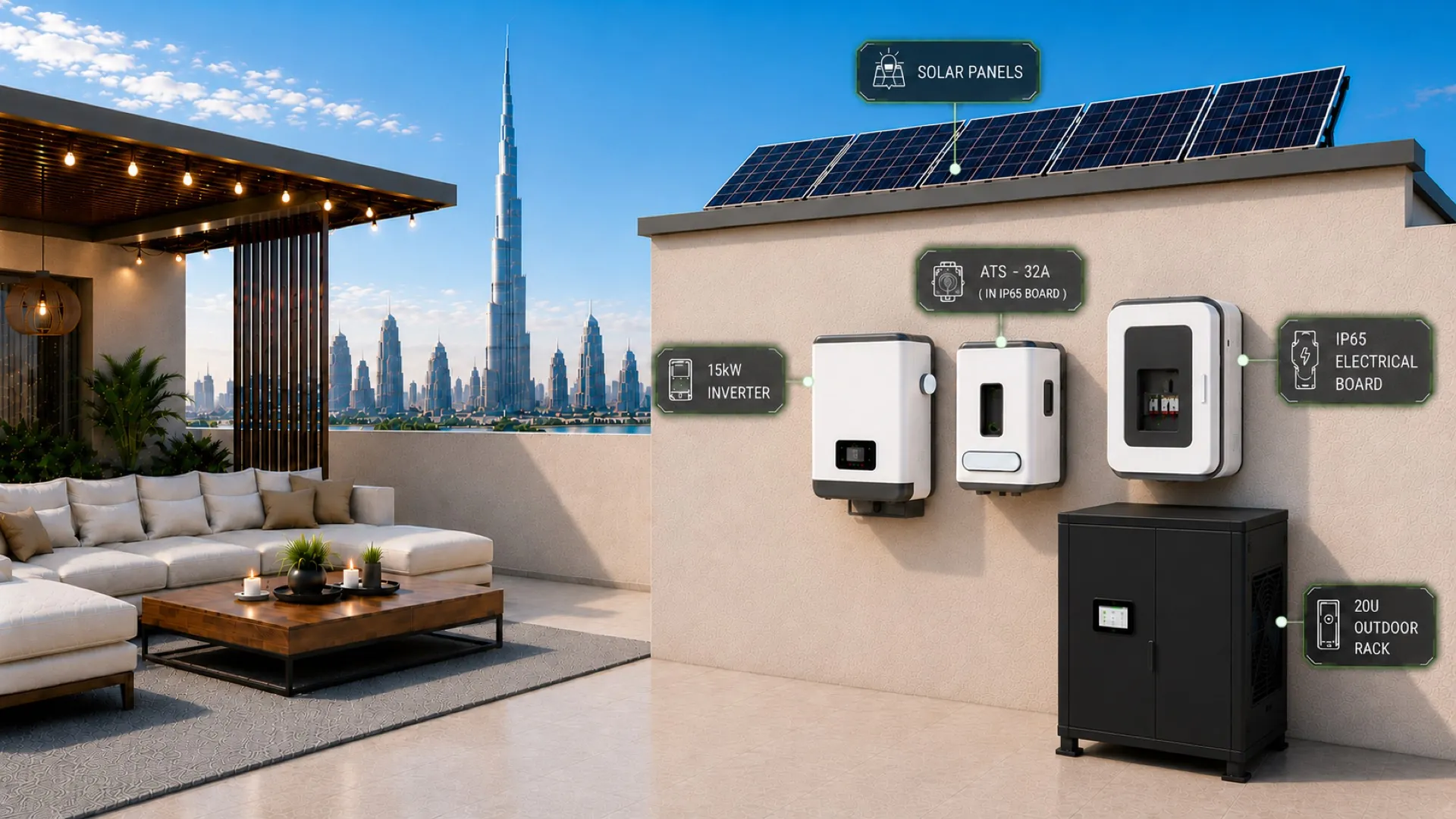

The node installed on a Dubai terrace with rooftop solar panels, a 15 kW inverter, a 32 A automatic transfer switch in an IP65 board, an IP65 electrical board and the 20U outdoor rack

Rooftop installation · Dubai, UAE · render for illustration only

01

A prepared slab or plinth

The node sits on a 600 mm plinth or a small prepared slab. No building, no raised floor, no white space.

02

A three-phase supply

400 V 3φ+N 50 Hz, TN-S earthing, 63 A main. Grid quality is a tolerance, not a prerequisite — the UPS regulates it.

03

Roof area for solar and the condenser

A rooftop array feeds a 15 kW inverter as the priority source; the condenser is roof-mounted with vertical upward discharge.

04

A network path

2 × 10GbE on board plus a BlueField-3 DPU. Northbound telemetry over Modbus TCP, SNMP v3 or MQTT to your NOC.

Site schematic

Solar array, inverter, transfer switch, node.

The complete installation is four elements on a wall and a roof. The automatic transfer switch holds the load on the solar-fed inverter while it stays in tolerance and moves to grid only on loss or out-of-tolerance — automatically, with no attendance.

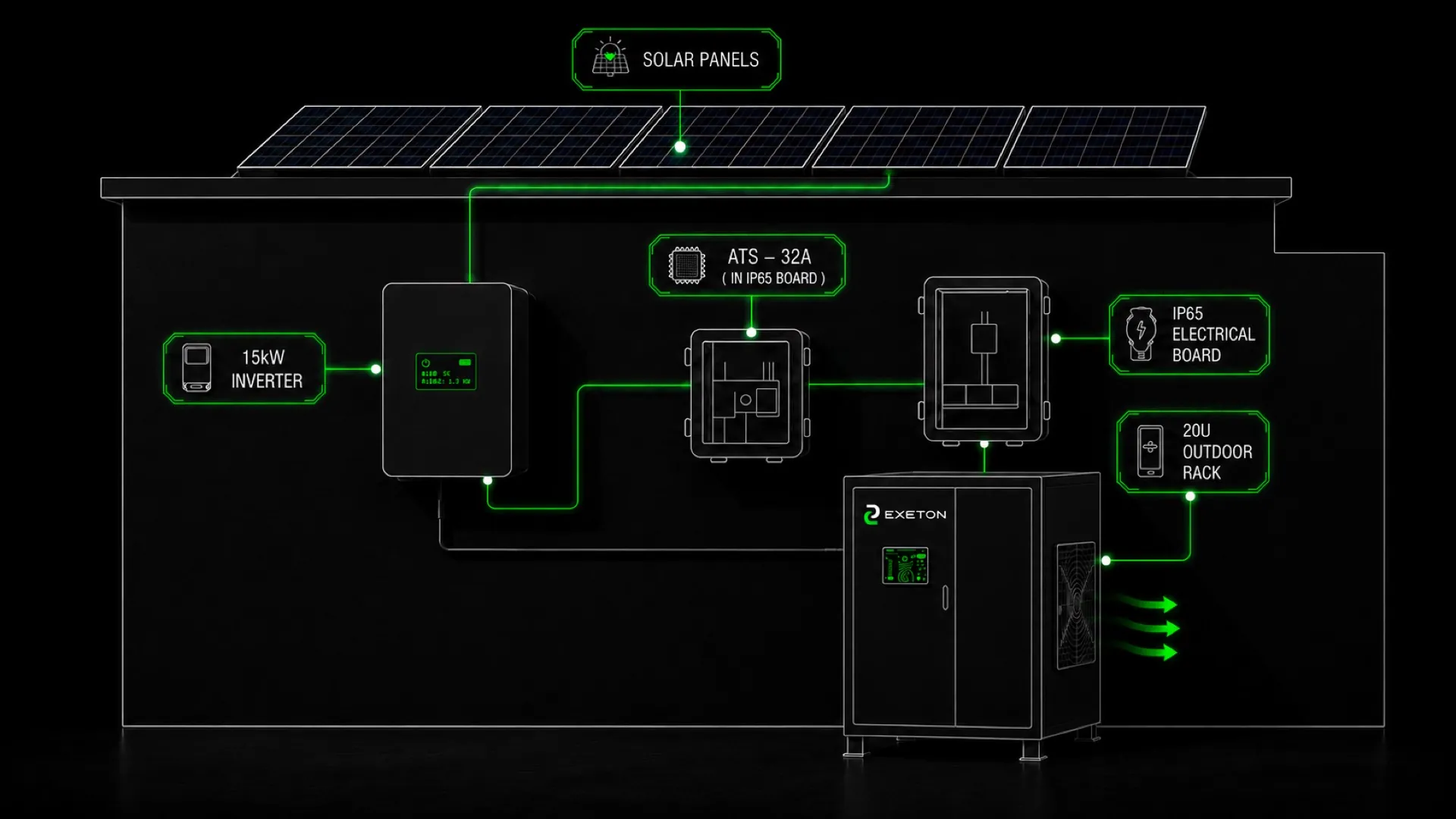

System schematic: solar panels feeding a 15 kW inverter, a 32 A automatic transfer switch in an IP65 board, an IP65 electrical board and the 20U outdoor rack

Where it goes

Compute placed where the workload is.

Anywhere a three-phase supply and a small slab exist — a terrace, a compound, a rooftop or a remote site — without building or leasing a data hall.

01

Banking & financial services

Institutions that will not export data to a shared facility can place inference capacity inside their own perimeter, on a rooftop or in a compound, without commissioning a data hall.

02

Government & sovereign AI

Data-residency requirements are satisfied by physical location rather than contract. A node is a discrete, auditable, relocatable unit of national compute capacity.

03

Defence

Self-contained power, cooling, fire protection and monitoring in a sealed IP55 envelope — deployable to compounds and remote sites where no facility exists and none will be built.

04

Latency-sensitive inference

Compute placed next to the workload rather than in a distant region. The node runs where the users and the data already are.

05

Industrial & remote sites

Anywhere a three-phase supply and a small slab exist. Solar-first power means grid quality at the site is a tolerance, not a prerequisite.

06

Silicon & platform partners

A reference deployment validating Blackwell-class GPUs and dual-socket EPYC in one of the harshest ambient environments on earth — instrumented end to end across a full Gulf summer.

Proof of concept

One node proven in a Gulf summer, then fifty.

The PoC is scoped at a single fully instrumented node subjected to a complete summer thermal soak at real ambient. A 50-unit rollout is contingent on validated results.

  1. 01Complete

    Design & select

    Platform, cooling and enclosure specification locked.

  2. 02In progress

    Procure

    Quotations, vendor selection and long-lead ordering.

  3. 03Planned

    PoC build

    Single node integrated, sealed and instrumented.

  4. 04Planned

    Field validation

    Full-summer thermal soak at real ambient.

  5. 05Planned

    Scale

    50-unit rollout on the validated design.

Current position: Phase 02 — platform selected, quotations in hand or pending across compute, thermal and enclosure.

50-unit rollout on validation
